Main Aims
This was a
daytime session to continue
formal commissioning of the new Dome Observatory including
:
Equipment & Software
Highlights
Back to Top

Fig 1.
Weather Flags showing Green with Value 0
Flags showing
Weather is ok whilst AllSky/Weather Computer is offline and not
sending data
(Giveaways are Clarity flag which shouldn't
be green if clarity value was actually 0
and the fact that
it was 14:40 on a summer day in June so light wouldn't be 0 and Temperature
wouldn't be 0 deg)
Back to Top
Observatory was given a thorough System Stress Test (Hardware & Software). This was done by auto-executing a full Observing Plan under close to real conditions using live scope slewing, slaved dome rotation and CCD camera imaging, but with the dome shutter closed, without high precision target centering using plate solution of locating images and with exposures shortened to 1s using a testing override.
An Observing plan for a long December night was built and executed (a future date had to be used otherwise the executor program would skip the targets as they were seen to be in the past). Of the 74 scheduled targets
- 61 targets were successfully acquired (with live telescope & dome slewing and CCD imaging)
- 10 targets failed (as per design) as they were below the horizon at the
time of execution or their airmass was outwith the permitted threshold
-
3 targets failed (as per design) as they had Declinations which were outwith the
permitted threshold (this is a safety measure to protect observatory equipment
and stop the CCD camera from hitting the LX200's fork base & control panel.
The stress test took 2 hours to run during which the system operated without problems, and importantly without any repetion of the earlier scope communication problem (Error Code 213). Whilst there is no guarantee that the '213' problem wouldn't reappear during future sessions, things at least appear hopeful for now and there is confidence to resume night-time testing & commissioning.

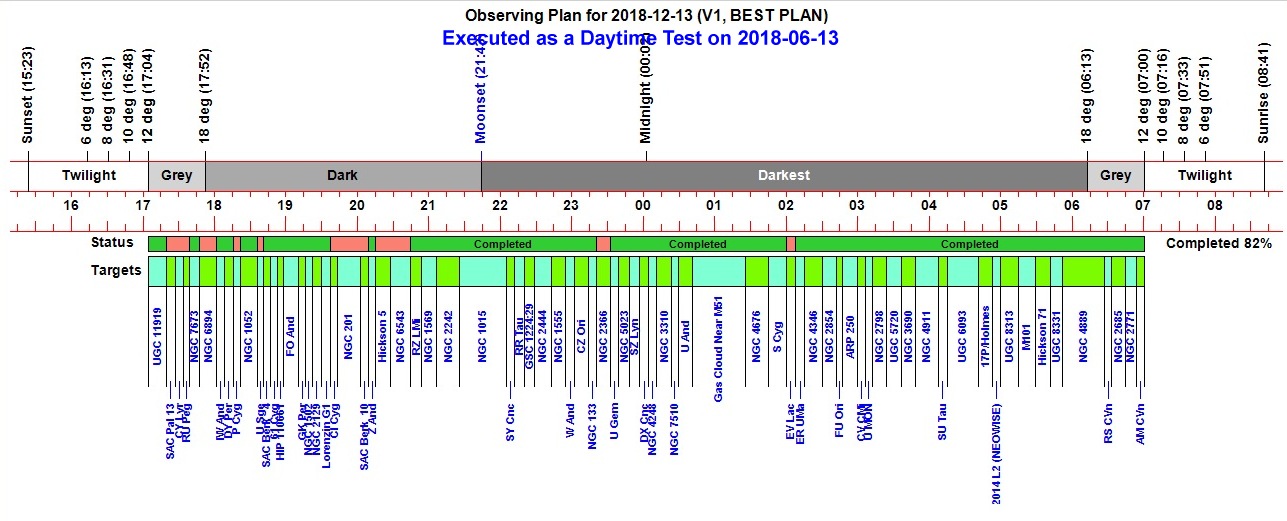

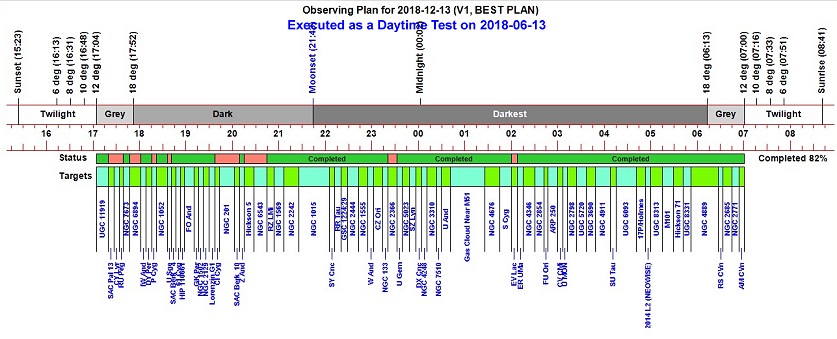

Observing Plan executed during stress test 2018-06-13 |
